Earned Value Management (EVM) is a powerful tool for tracking project progress. It combines scope, schedule, and cost to give you a clear picture of how your project is doing. Think of it as a project health check-up that tells you if you're on track or need to make changes.

EVM uses key metrics like Planned Value, Earned Value, and Actual Cost to measure performance. These numbers help you spot issues early, make smart decisions, and keep stakeholders in the loop. It's like having a GPS for your project, showing you where you are and where you're headed.

EVM Basics

Core EVM Components

  • Earned Value Management (EVM) integrates project scope, schedule, and cost management to assess project performance and progress
  • Planned Value (PV) represents the budgeted cost of work scheduled at a specific point in time
  • Earned Value (EV) measures the authorized work physically completed expressed as the planned budget for that work
  • Actual Cost (AC) reflects the total costs incurred to accomplish the work performed up to a specific date
  • Budget at Completion (BAC) denotes the total planned value for the entire project

EVM Implementation and Benefits

  • EVM provides early warning signals for project performance issues
  • Helps project managers make data-driven decisions by comparing planned, earned, and actual values
  • Enables accurate forecasting of project cost and schedule performance
  • Facilitates better communication with stakeholders about project progress
  • Supports proactive project management by identifying trends and potential risks
Core EVM Components, Earned value management (EVM) | Flickr - Photo Sharing!

EVM Data Collection and Reporting

  • Requires systematic collection of project data throughout the project lifecycle
  • Utilizes work breakdown structure (WBS) to organize and track project activities
  • Involves regular reporting periods (weekly, monthly) to assess project status
  • Incorporates baseline updates to reflect approved changes in project scope, schedule, or budget
  • Generates visual representations (S-curves, charts) to illustrate project performance trends

EVM Variances and Indices

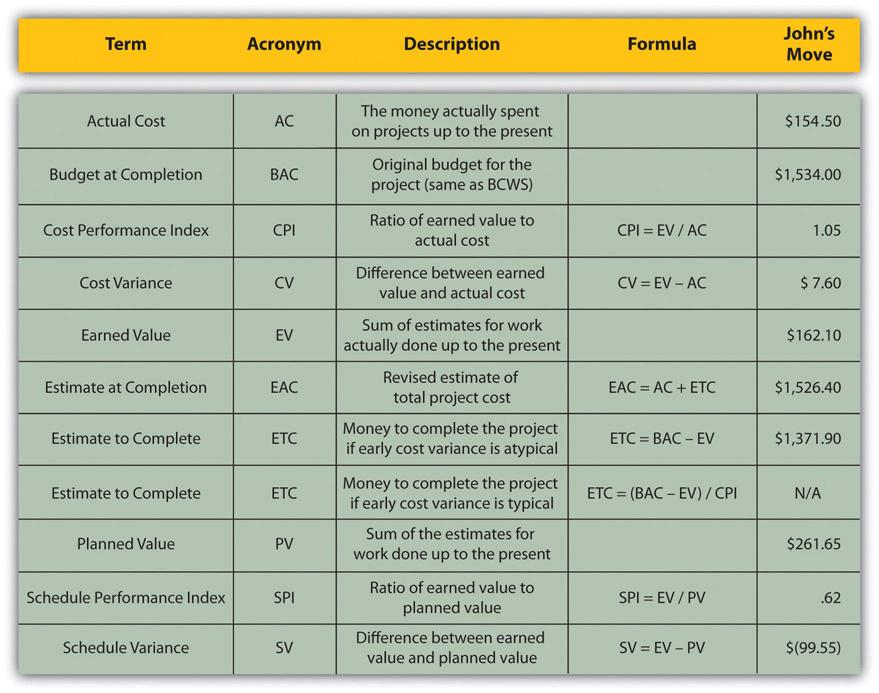

Core EVM Components, 12. Budget Planning – Project Management

Schedule Performance Metrics

  • Schedule Variance (SV) calculates the difference between earned value and planned value (SV=EVPVSV = EV - PV)
  • Positive SV indicates the project is ahead of schedule, while negative SV suggests a delay
  • Schedule Performance Index (SPI) measures schedule efficiency (SPI=EV/PVSPI = EV / PV)
  • SPI greater than 1 indicates the project is progressing faster than planned, while SPI less than 1 suggests slower progress
  • These metrics help identify schedule slippages and assess the impact on project timeline

Cost Performance Metrics

  • Cost Variance (CV) determines the difference between earned value and actual cost (CV=EVACCV = EV - AC)
  • Positive CV signifies the project is under budget, while negative CV indicates cost overruns
  • Cost Performance Index (CPI) evaluates cost efficiency (CPI=EV/ACCPI = EV / AC)
  • CPI greater than 1 shows the project is spending less than budgeted, while CPI less than 1 indicates overspending
  • These metrics assist in identifying budget issues and forecasting final project costs

Interpreting EVM Metrics

  • Combine SV and CV to assess overall project health (ahead/behind schedule and under/over budget)
  • Use SPI and CPI together to evaluate project performance efficiency
  • Track trends in these metrics over time to identify patterns and potential issues
  • Compare these metrics against predetermined thresholds to trigger corrective actions
  • Utilize these metrics for accurate project forecasting and decision-making processes
